Commercial solar roof survey: what we check before anyone quotes

Facilities managers are rightly more worried about the roof than about the panels. Warranty, structural loading, fire and asbestos all come before savings. The survey deals with those first, and everything it measures is the reason a quotation is a real number rather than a rate card.

no fee  /  the document is yours  /  half a day on site

Do I need a roof survey before installing solar panels?

A roof survey before installing solar panels is a structural and condition assessment that establishes what a commercial roof can carry, whether the covering has the service life to justify an array, and whether anything up there rules out the mounting system a designer would otherwise assume.

On a commercial building the answer is therefore yes. Most solar installers will not put a firm price on an industrial roof without one, and the ones who will are pricing a set of assumptions rather than your building.

The benefits of running the survey before solar installation are mostly financial. A survey before installing solar panels finds the asbestos cement sheet, the corroded gutter line and the purlin spacing that would otherwise arrive as variations halfway through the work. It also leaves you with a document you can put in front of more than one contractor, so you are comparing prices for the same scope rather than comparing assumptions.

There is a third reason to survey before installing. Roof condition assessment evidence is what your insurer and your landlord ask for, and gathering it once the panels are on the roof is considerably harder than gathering it now. Commercial roofs on industrial estates are also rarely as they were drawn, because plant, mezzanines and earlier repairs accumulate, and every one of those changes the design.

ON SITE
Half a day
for a single warehouse roof, with the desk work taking longer
WATCH FOR
A firm price on an industrial roof nobody has been on

Structural loading and what the frame will take

Structural loading is the permanent dead load an array adds to a building, plus the wind uplift it catches on a flat roof, where the array is also a sail.

The survey records the structural arrangement we can see and gathers what is needed for an engineer to check it: purlin spacing and section, sheet span, the rafter or portal frame layout, and any earlier alterations such as added plant, mezzanines or roof penetrations. Purlin centres are the spacing between the steel members that carry the roof sheet, and they decide where a mounting rail can be fixed at all.

That package goes to a structural engineer alongside the solar panel mounting manufacturer's published dead load, with wind and snow actions taken from the Eurocodes, BS EN 1991-1-4 and BS EN 1991-1-3. Two outcomes are common and both are useful. Either the frame takes the proposed system, in which case the design proceeds, or it takes a lighter or smaller one, in which case you know the real usable capacity of the building before anyone has quoted for something it cannot carry.

SOURCE
BS EN 1991-1-4 for wind actions, BS EN 1991-1-3 for snow
WATCH FOR
Added plant, mezzanines and earlier roof penetrations
FIG. 1 The three actions on a roof carrying an array
dead load array, rails and fixings wind uplift BS EN 1991-1-4 snow load BS EN 1991-1-3 purlin roof sheet frame frame load path: sheet to purlins to frame to foundations

Schematic and not to scale. The array is a permanent dead load, the wind action can act upward as suction at the edges of the array, and the snow action loads the sheet between purlins. All three are checked together, which is why a mounting weight on its own never answers the question.

Schematic cross section, not to scale. The mounting manufacturer supplies the dead load. The wind and snow actions come from the Eurocodes and depend on the site, the building height and the position of the array on the roof. Source: BS EN 1991-1-4 for wind actions and BS EN 1991-1-3 for snow actions

Cladding profile: standing seam, trapezoidal and membrane

The cladding profile is the shape and fixing system of the roof covering, and it decides the mounting method before any other factor does. It is the first thing we identify on site.

Standing seam

Standing seam is a metal roof system whose sheets are joined by a raised upstand. Solar panel clamps grip that seam, so the array is fixed without a penetration through the sheet. It is the cleanest case for the weathertightness of the roof and often the easiest one to reconcile with a manufacturer warranty.

Trapezoidal profiled sheet

Trapezoidal profiled sheet is the ridged metal cladding most warehouses are built with. Rails fix into the crown of the profile with sealing washers, set out to land above purlins. Profile geometry, sheet gauge and the condition of the coating all feed into the fixing pattern and the number of fixings per rail.

Single ply or built up flat roof

Usually a ballasted frame on protection mats, tilted and spaced so the rows do not shade each other. Ballast weight is what holds it down, so this is the case where structural headroom matters most.

Composite panel

Insulated composite panels behave differently again, and the fixing has to reach the supporting structure rather than relying on the outer skin. We record the panel type and its thickness rather than guessing from the profile.

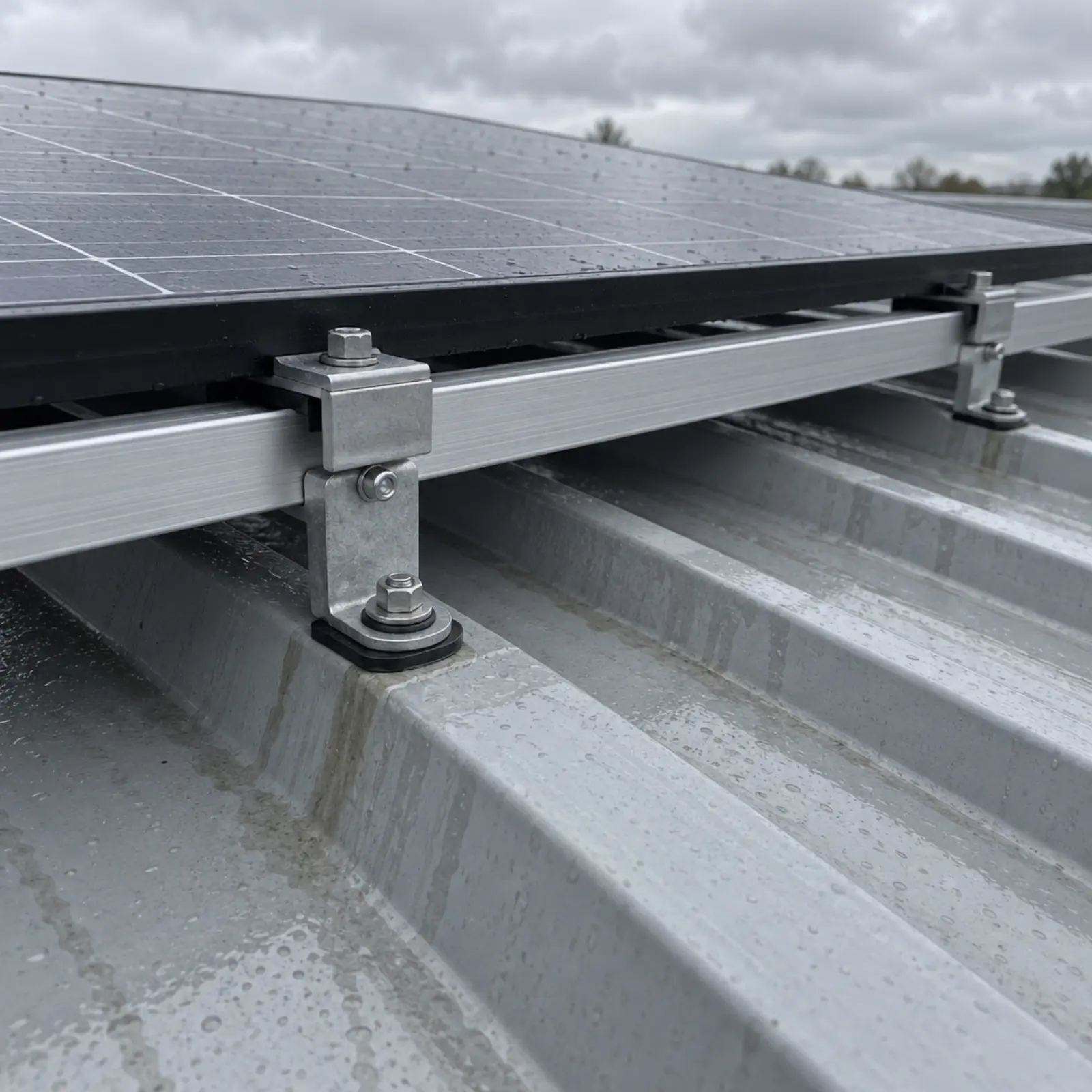

Mounting feet fixed into the crown of a trapezoidal steel roof profile, with rail spanning the ribs beneath a panel edge
A mounting rail clamped to the upstand of a standing seam roof, with cable tray run alongside the row. Nothing pierces the sheet, which is the detail a roof warranty turns on.
FIG. 2 Cross sections: how an array fixes to each covering

The four coverings, and how an array fixes to each

purlin
Trapezoidal sheet Clamped into the crown, or through-fixed with a sealed washer The most common industrial covering. Rail sits on the crowns, so the load lands on the purlins rather than the pan.
purlin clamp, no penetration
Standing seam Non-penetrative seam clamp The best case. Clamps grip the upstand, nothing pierces the sheet, and the roof warranty usually survives intact.
purlin ballast tray, tilted frame
Single ply membrane Ballasted or adhered trays on a flat deck Flat roofs take a tilted frame. Ballast adds weight, so the structural check matters more here than anywhere else.
purlin fragile, controlled work
Asbestos cement sheet No direct fixing. Over-sheet or replace first Fragile, and disturbing it is controlled work under the Control of Asbestos Regulations 2012. We identify it and price the options rather than working around it.
Sections rather than photographs, because the fixing detail is what decides whether a roof can take an array and a photograph hides it. Drawn schematically and not to scale. Source: Mounting methods for the four coverings described above
Asbestos, fire and insurance

Asbestos cement sheet, identified rather than avoided

Asbestos cement sheet is a fragile fibre reinforced roof covering that a large share of UK industrial stock built before the mid 1980s still carries, as roof sheet or as gutter lining.

It cannot be walked on, and work on it is regulated. The Control of Asbestos Regulations 2012 place a duty to manage asbestos on whoever controls the building, and any drilling or fixing into the material has to be planned and carried out under those regulations rather than treated as ordinary roof work.

We ask for the asbestos register at the point of booking, and if there is not one that is itself a finding. Where a survey identifies asbestos cement, there are normally three honest options: re-sheet the roof through a commercial roofing contractor and mount on the new covering, install on a structure that does not load the sheet, or leave the roof alone. On an older covering the re-sheet option is often better value than it first looks, because it resets the service life of the roof under an array that will be there for decades. We set out what each route does to the cost on the cost and payback page.

SOURCE
2012
Control of Asbestos Regulations, and the duty to manage
WATCH FOR
No asbestos register at all, which is itself a finding

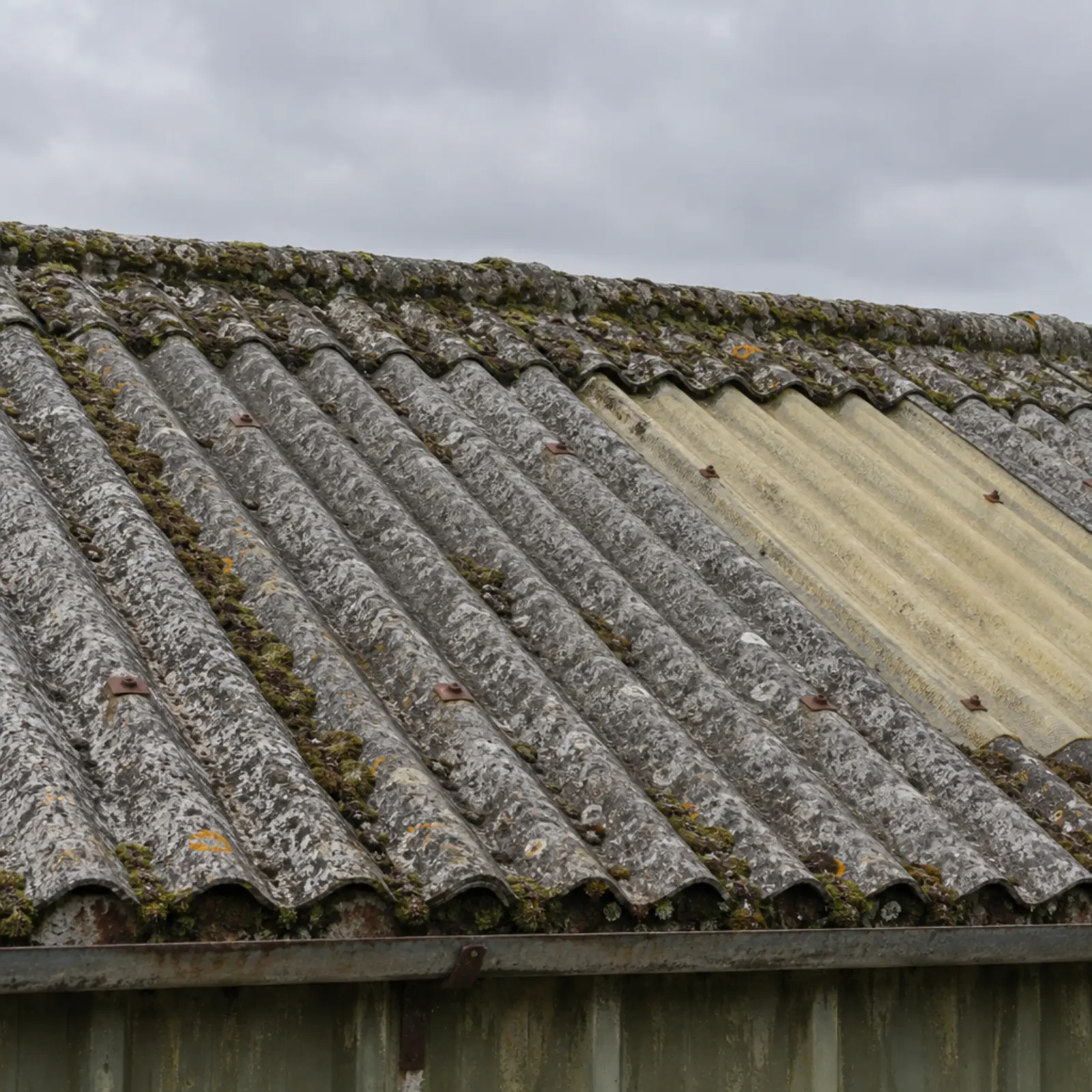

Weathered corrugated asbestos cement roof sheeting with moss along the laps and an aged rooflight panel
Weathered corrugated asbestos cement sheet, with moss along the laps and an aged rooflight panel. Age and profile are a prompt to check the register, never a substitute for a sample and a laboratory result.

RC62 fire safety and what your insurer will ask

RC62 is the RISCAuthority guidance on fire safety with photovoltaic panel installations, and it is the document UK commercial property insurers most often reference when they are asked to accept a rooftop array.

A rooftop array is a DC electrical installation covering a large area of a building your insurer has already priced. It is not building regulations, but on a warehouse it can matter more, because the insurer can decline or load the cover.

The themes it deals with are the ones we look for on the survey: how DC cabling is routed and protected, where isolation sits and whether it can be reached safely, keeping the array clear of compartment walls so it does not bridge a fire separation line, leaving access routes and clear zones for the fire service, and the documentation handed over at completion. Large single compartment sheds and buildings storing high calorific value goods attract the most scrutiny. Telling your insurer early, and designing to what they say, costs nothing. Finding out afterwards is expensive.

Usable area, rooflights and shading

Usable area is the roof area left once everything that cannot carry an array, or would shade one, has been taken out, and it is always smaller than gross roof area.

Rooflight strips, smoke vents, plant, air handling units, walkways, safety line runs and edge exclusion zones all come out first. So does anything that casts a shadow across the day: parapets, adjacent taller industrial units, flues and lift overruns.

Older glass reinforced plastic rooflights are a safety matter in their own right, since they degrade and are fragile long before they look it, and they need covering or protecting for the duration of the works. What is left after all of that is the usable area, and it is the only figure worth converting into kWp, the kilowatt peak rating of an array under standard test conditions. The modelled yield we apply to it comes from EU PVGIS v5.2 for your latitude, pitch and orientation, and the locations index carries the figure we use for each county.

SOURCE
PVGIS v5.2
modelled yield for your latitude, pitch and orientation
WATCH FOR
Older glass reinforced plastic rooflights, fragile before they look it

Remaining sheet life and the roof warranty

Remaining sheet life is the number of years a roof covering has left before it needs replacing, and it has to outlast the array bolted to it.

A modern array has a working life measured in decades. A roof covering two thirds of the way through its own life does not, and removing and refitting an array to re-sheet underneath it is a cost nobody budgets for at the outset. We record coating condition, corrosion at fixings and laps, gutter and flashing condition, and any signs of water ingress, then say plainly how much life we think the covering has left. That condition assessment is the finding that most often changes the order of the work.

Where a manufacturer or membrane warranty is still running, its terms usually govern what may be fixed to the roof and who may do it. Sending us the warranty documentation at the start means the mounting method is chosen around it. If the roof is close to end of life, re-sheeting and then mounting is frequently the cheaper sequence over the life of the asset, and it is worth testing that against the funding routes on the finance and PPA page, because a longer lived roof supports a longer agreement.

The connection and the export limit

An export limit is the maximum output a distribution network operator will allow your system to put onto the local network, and it is agreed before the design is fixed rather than after.

The last item on the survey is therefore not on the roof at all. We record the incoming supply, the MPAN, which is the unique reference number for your electricity supply point, the existing switchgear and the available headroom, and identify the distribution network operator for your area. Smaller systems connect under G98 by notification. Larger ones need a G99 application, the formal route for a generator the network has to assess, and an agreed export limit before the design is fixed. Knowing which applies, and what limit is realistic for your area, stops a scheme being sized on a roof plan and then cut back months later.

All of that lands in one pack of reports with the roof plan, the usable area, the array size in kWp, the modelled generation against your half hourly consumption, and the constraints we found. It is free and it is yours to keep, whoever installs.

ROUTE
G98 / G99
notification for smaller systems, an application for larger ones
RECORDED
Incoming supply, MPAN, switchgear and available headroom

Which surveys a rooftop solar design needs

A rooftop solar design needs a short stack of surveys rather than a single one, and on an industrial building knowing which of them you already hold saves time and money. People say roof survey as though it were one document.

ITEM
SURVEY
WHAT IT COVERS, AND WHO USUALLY HOLDS IT
A

Condition surveys

Drone and walked condition surveys record coating, corrosion, laps, drainage and rooflights. Recent condition assessments from a roofing contractor often cover most of this, so send them before we book anything.
B

Structural surveys

Measured surveys of purlins, spans and frame, gathered for the engineer. Most warehouses have none on file, which is why structural surveys are the item that usually sets the timetable.
C

Asbestos surveys

A management survey under the duty to manage, plus a refurbishment survey where fixings will disturb the material. These surveys belong to the duty holder, not to us.
D

Electrical surveys

Switchgear, incoming capacity and metering. Where a solar panel array will land on an older board, these surveys decide whether the connection is a day of work or a project of its own.
FIG. 3 The survey day, in order
  1. 01 Access and safety on the roof safe route set out, fragile rooflights identified
  2. 02 Structure and covering on the roof purlin spacing and section, sheet span, frame layout, coating condition
  3. 03 Usable area on the roof rooflights, plant, walkways and shading measured out of the gross footprint
  4. 04 Electrical intake and metering in the switchroom switchgear headroom, incoming capacity, MPAN
  5. 05 Connection enquiry after the visit the G98 or G99 route raised with the network operator for the area
  6. 06 Report issued after the visit one pack, yours to put in front of more than one contractor

The order is not arbitrary. Nothing above the structural step is worth measuring if the frame will not take the load, which is why the structural item is the one that usually sets the timetable. The connection enquiry goes in while the report is being written rather than after it, because that answer takes the longest to come back.

The order of the visit itself, not the project. No durations are drawn on it, because the only timing figure we will put a number against is the half day on site. Source: The sequence the survey follows on an industrial roof

What the survey reports contain

A commercial solar roof survey produces documents rather than opinions.

These are the reports that come out of it, and the reports a funder, an insurer or competing solar installers will ask to see before anyone commits to the work.

Those reports travel together in one pack. Once it exists, repeat surveys are rarely needed, and the same reports serve the insurer, the funder and whoever installs. We survey warehouses, cold stores, manufacturing units and trade counters across most industrial sectors, and the format stays the same across sectors so that a reader who has seen one pack can read every other one quickly.

Planning permission, compliance and the regulatory picture

Permitted development is the planning route most rooftop solar on an industrial or commercial building in England takes, under Schedule 2, Part 14 of the Town and Country Planning (General Permitted Development) (England) Order 2015 and subject to the limits and conditions that order sets out.

That is not the same as needing nothing. Listed buildings, conservation areas, sites carrying planning conditions that restrict roof alterations, and arrays that fall outside those limits all need a planning application, and some cases need prior approval instead.

The survey captures what a planning case would need if one turns out to be required: the roof plan, the array outline, the height above the covering and the visibility from the highway. Planning officers and insurers ask for exactly these drawings, and having them ready is the difference between a fortnight and a quarter.

Compliance runs alongside planning rather than after it. The regulatory items that touch a commercial roofing project of this kind are the Control of Asbestos Regulations 2012, the structural Eurocodes BS EN 1991-1-4 and BS EN 1991-1-3, the Building Regulations where structural alteration is involved, the distribution network operator process under G98 or G99, and your insurer's own requirements, which on commercial roofing work usually means RC62. We record the compliance position for each of them in the survey so nothing is discovered late.

Book the survey

Tell us what is on the roof

Send the postcode, the rough footprint and anything you already know about the covering. If you have an asbestos register, a roof warranty or recent condition reports, those shorten the whole process considerably.

Lenzie Consulting Ltd arranges the survey, the design and the installation through an MCS-certified partner, and passes your details to them so they can quote. No survey fee, no obligation to proceed.

We pass your details to our MCS-certified installation partner so they can quote. Read the privacy notice.

Questions about roofs and mounting

Can you put solar panels on a metal roof?
A profiled metal roof is one of the easier coverings to mount solar panels on, so the answer is usually yes. Standing seam, which is a metal roof system whose sheets are joined by a raised upstand, takes non penetrative clamps that grip the seam, so nothing is drilled through the sheet at all. Trapezoidal profiles take fixings into the crown of the profile with a sealing washer, set out to land on the purlins below. What decides it is the sheet gauge, the profile geometry, the coating condition and how much life the covering has left, all of which the survey records.
Can you put solar panels on an asbestos roof?
An asbestos cement roof can carry solar panels, but it is a decision to take deliberately rather than by default. Asbestos cement sheet is a fragile fibre reinforced covering that cannot be walked on, and drilling or fixing into it is work regulated under the Control of Asbestos Regulations 2012, which also place a duty to manage on whoever controls the building. On an older asbestos roof the arithmetic often favours re-sheeting first, because the array then sits on a covering with a full service life ahead of it. We identify asbestos on the survey and price the options rather than working around it.
Will solar panels invalidate my roof warranty?
A manufacturer or single ply membrane warranty usually sets out what may be fixed to the covering and by whom. On a membrane roof, ballasted systems that avoid penetrations are often the route that keeps the warranty intact. On a profiled metal roof, using the fixing type and sealing detail the manufacturer specifies is the equivalent. We ask for the warranty documentation before the design is fixed, so the mounting method is chosen around it rather than checked afterwards.
What is RC62 and will my insurer ask for it?
RC62 is the RISCAuthority guidance on fire safety with photovoltaic panel installations, written for the UK insurance market. Many commercial property insurers reference it when they are asked to accept a rooftop array. It covers matters such as DC cable routing and protection, isolation arrangements, keeping the array clear of compartment lines, access for the fire service and the information handed over at completion. Raising it with your insurer before the design is finalised is far cheaper than retrofitting a change after installation.
How much weight do solar panels add to a roof?
Solar panels add a dead load that the mounting manufacturer publishes in kilograms per square metre for the system as a whole, and that figure, together with wind and snow actions under the Eurocodes, goes to a structural engineer with the roof drawings. A coplanar array on a pitched metal roof adds relatively little. A ballasted system on a flat roof adds considerably more, because the ballast is what resists wind uplift. The survey establishes which system suits your roof before anyone calculates a load.
How much should a roof survey cost?
Our commercial solar roof survey carries no fee, because our MCS-certified installation partner funds it in the expectation of being asked to quote, and the report is yours to keep whoever ends up doing the work. Independent roof surveys bought on the open market are priced by scope and access rather than by a standard rate, so a drone condition assessment, a structural loading report and a full intrusive investigation are three different prices. We do not publish a market figure for work we do not carry out or control.
What is the average cost of a commercial property survey in the UK?
A commercial property survey is priced by scope rather than by a standard rate, so no single average is worth quoting. The category covers everything from a short condition report on a small industrial unit to a full building survey on a multi-let estate. Surveyors price by floor area, building age, access and the depth of investigation, and a solar specific roof survey is narrower than a general building survey because it is aimed at one question: what the roof can carry and for how long. Ask two firms for a fee proposal against the same written scope rather than comparing averages.
What is the 20% rule for solar panels?
The 20 percent rule is not part of UK building regulations, planning law or the network connection process, and no such rule exists anywhere in them. On a commercial roof the real limits are the structural capacity the engineer confirms, the usable area left after rooflights, plant, walkways and exclusion zones, the state of the covering, and the export limit the distribution network operator will agree. Each of those is measured on the survey, and none of them is a fixed percentage of anything.
How long does a commercial roof survey take?
A commercial roof survey takes about half a day on site for a single warehouse roof, depending on access and the size of the footprint. The desk work that follows, modelling generation against your half hourly consumption and confirming the network position, takes longer than the visit itself. There is no fee and the resulting reports are yours to keep, whoever ends up installing.
